Skip to content
Digital Transformation

Digital Transformation for Proactive Project Risk Management and Reporting

Digital Transformation for Proactive Project Risk Management and Reporting

Proactive project risk management is the discipline of identifying, quantifying, and responding to risk before it disrupts cost or schedule, rather than reacting after the fact. On a capital construction project, it works best when it runs on a single Project Management Information System (PMIS) that connects the risk register to budgets, stage gates, change orders, and reporting, so every risk decision is traceable across the portfolio.

Uncertainty is inherent in every project delivery, and capital construction projects most of all. By nature, projects commit to delivering future products and services based on what is known today. What makes capital construction harder is scale and duration: there is constant pressure to deliver cheaper and faster, yet these projects often take at least five years, long enough that many original assumptions become invalid and new uncertainties emerge.

Regardless of how much knowledge and experience project stakeholders bring, predicting what might happen and its impact on project success is hard. That difficulty comes from factors including each project's uniqueness, the deliverables produced, many stakeholders with conflicting requirements, the assumptions made, the constraints imposed, the different individuals involved, and the changes made when responding to unknowns.

Why capital construction projects need proactive risk management

The goal of a proactive project risk management system is not to eliminate risk but to increase the organization's ability to accept risk so the rewards can be greater. That means putting measures in place to reduce the cost of threats, or negative risks, while increasing the rewards of opportunities, or positive outcomes. Together, these measures raise the return on investment (ROI) of the projects an organization undertakes.

Proactive project risk management starts with a team formally assigned to manage project risk, just as other project aspects are managed. This team enforces a well-defined framework that makes risk part of every decision to select, execute, change, or terminate a project. Those decisions are the Stage Gate decisions made when exiting each project life cycle stage to secure approval to proceed to the next. The framework also defines the business processes needed to identify, assess, evaluate, respond to, monitor, control, and conduct post-project review of project risks.

Using a PMIS solution like PMWEB, risk management becomes one of many project management functions that can be digitized with out-of-the-box, integrated business processes to proactively manage, monitor, evaluate, and report risk across the entire project portfolio.

Build the risk team and governance framework

Start by defining who manages project risk and which roles are needed to build the risk team. The organization chart also sets the lines of authority for those roles, establishing responsibility for each project risk management business process. The PMWEB organization module maps the project risk management function's organization chart.

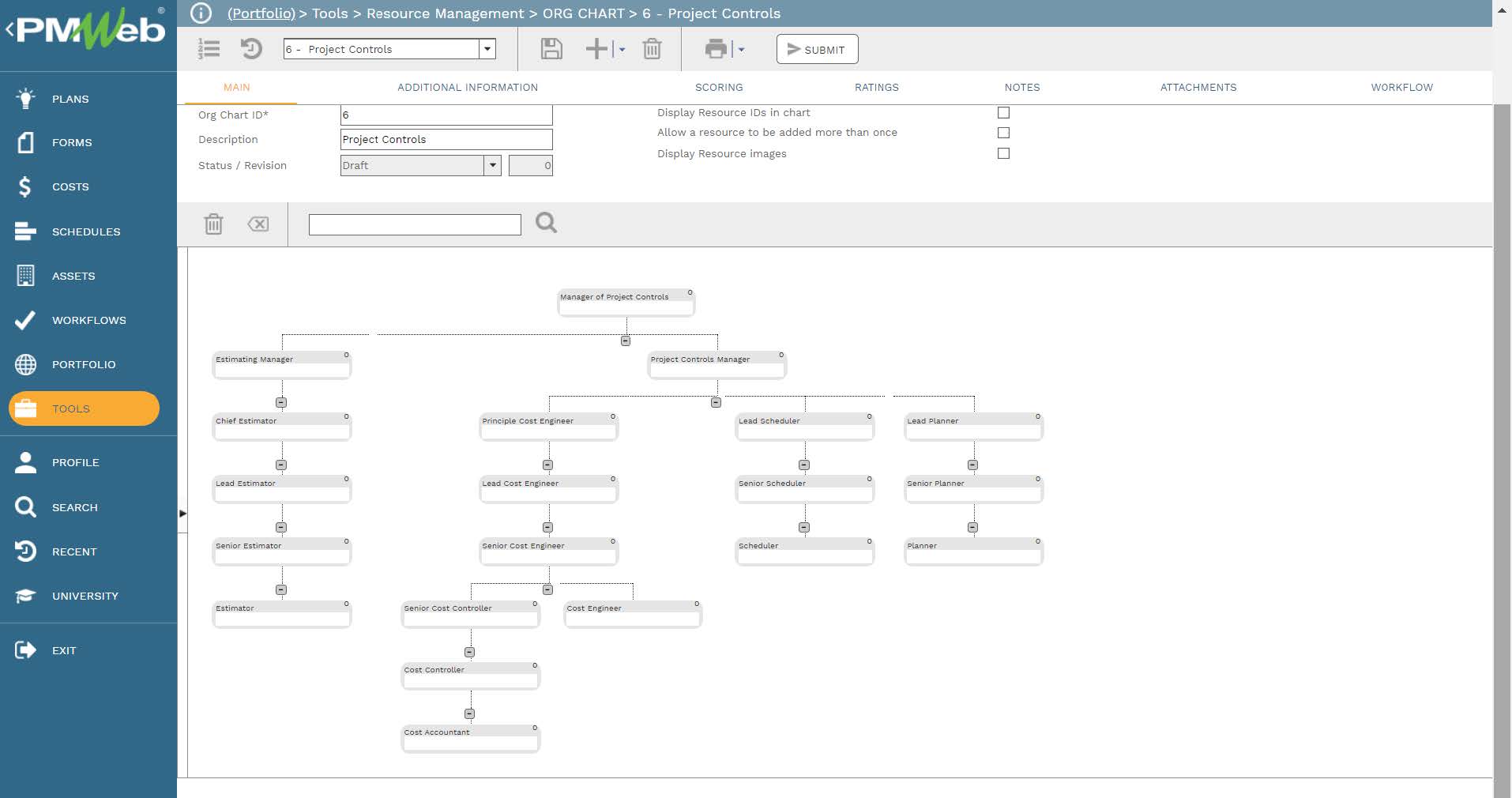

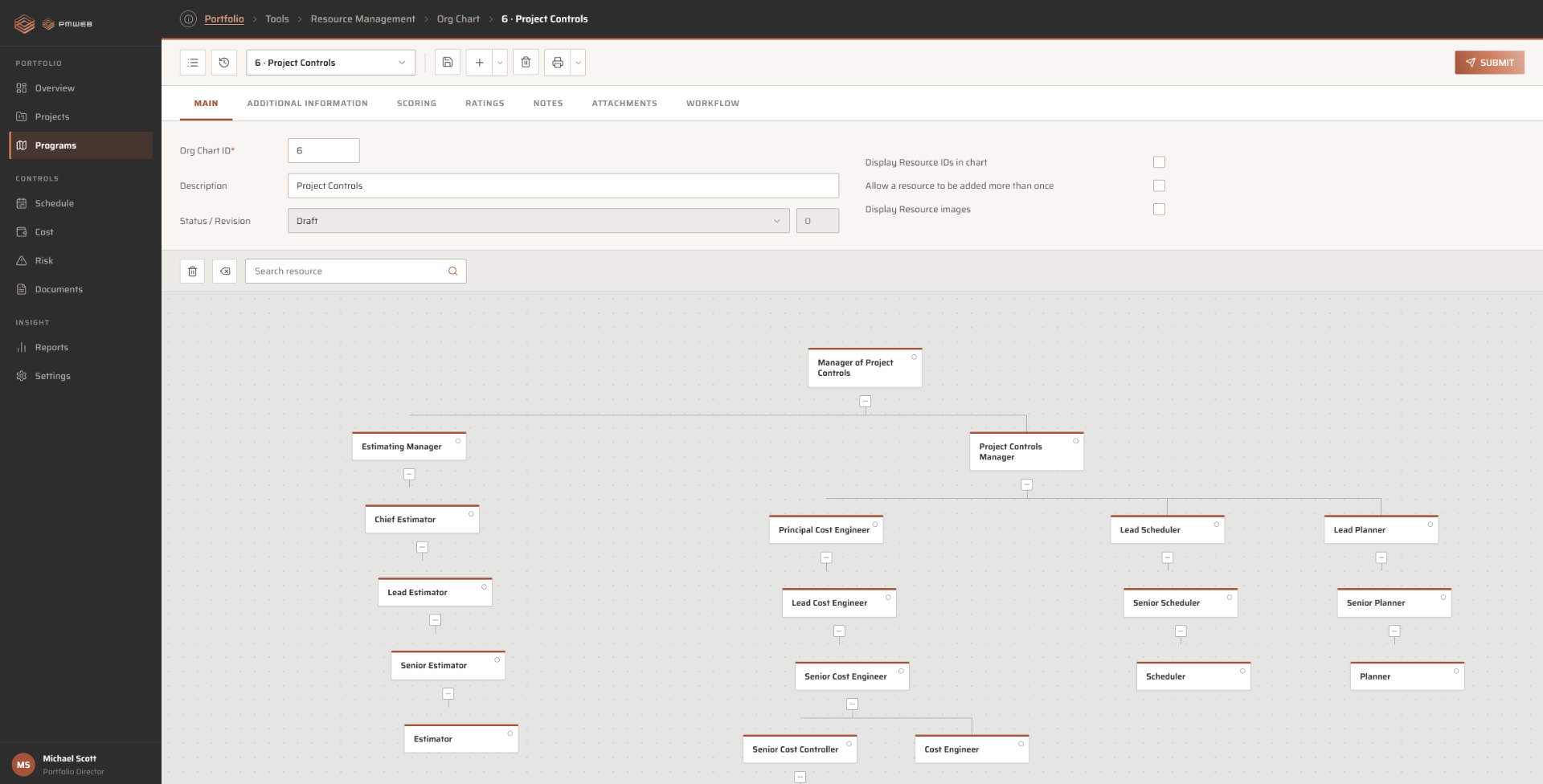

PMWEB organization module mapping the project risk management team and lines of authority

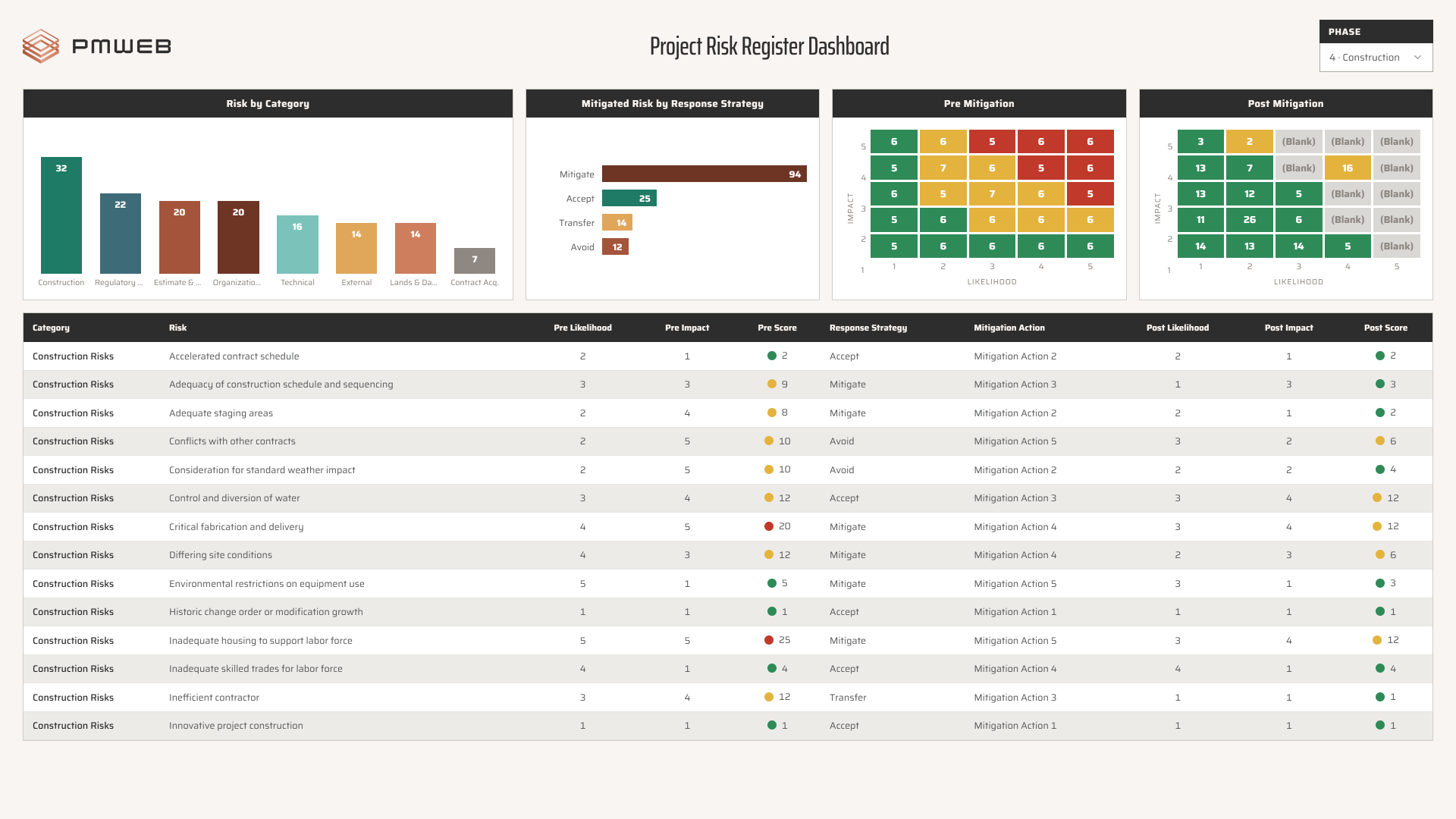

Identify and assess risks in the risk register

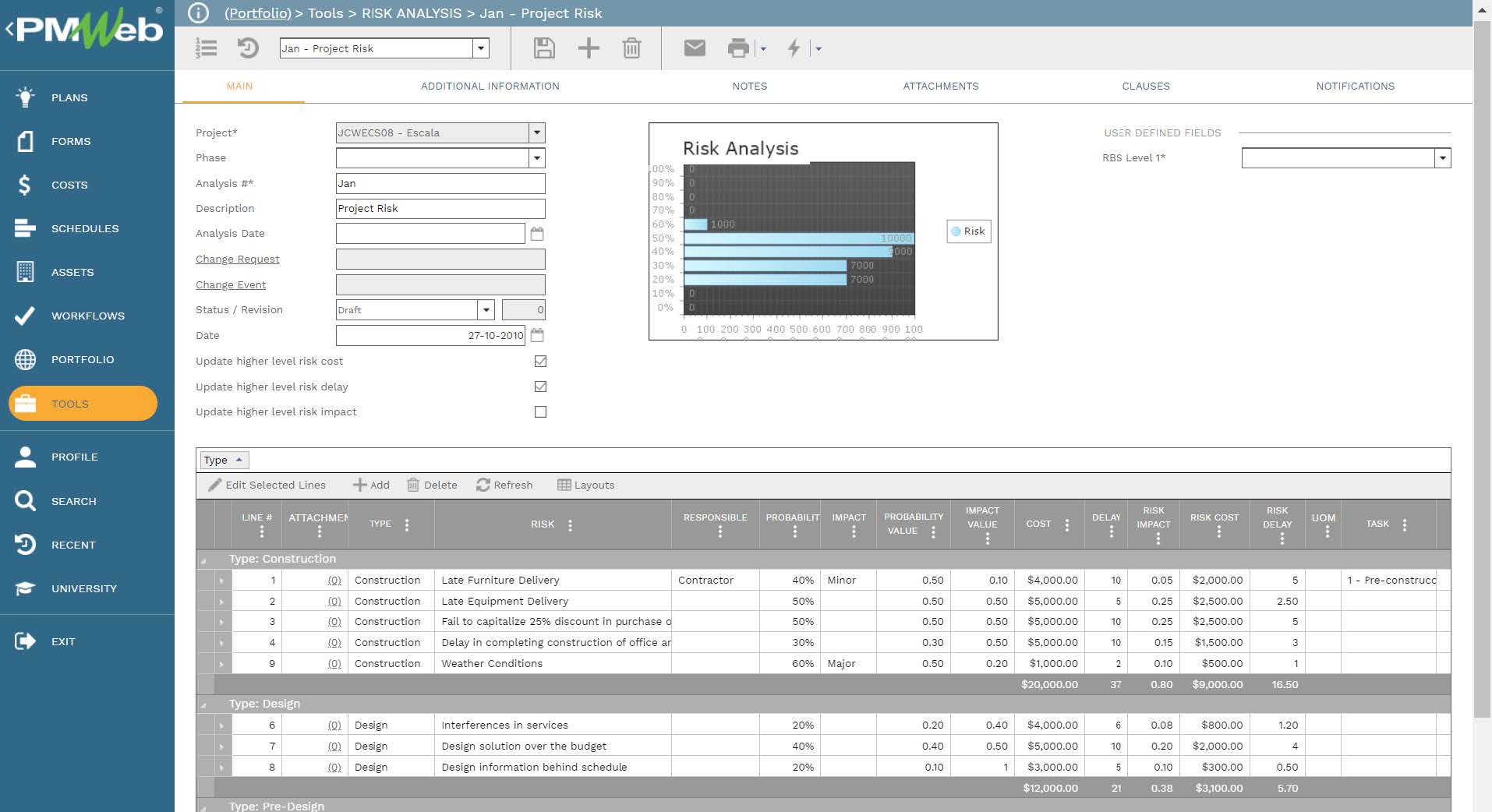

Risk identification, qualitative assessment, evaluation, and response strategy are managed in the PMWEB risk analysis module. There is no limit to the number of risk registers you can add to align with your risk management framework. Each register identifies risks by category and captures their pre-mitigation and post-mitigation impact and probability of occurrence.

The register also quantifies the expected cost exposure of each identified, evaluated, and treated risk, known as the "Risk Cost." PMWEB calculates this value automatically by multiplying the residual cost impact by the risk's probability of occurrence.

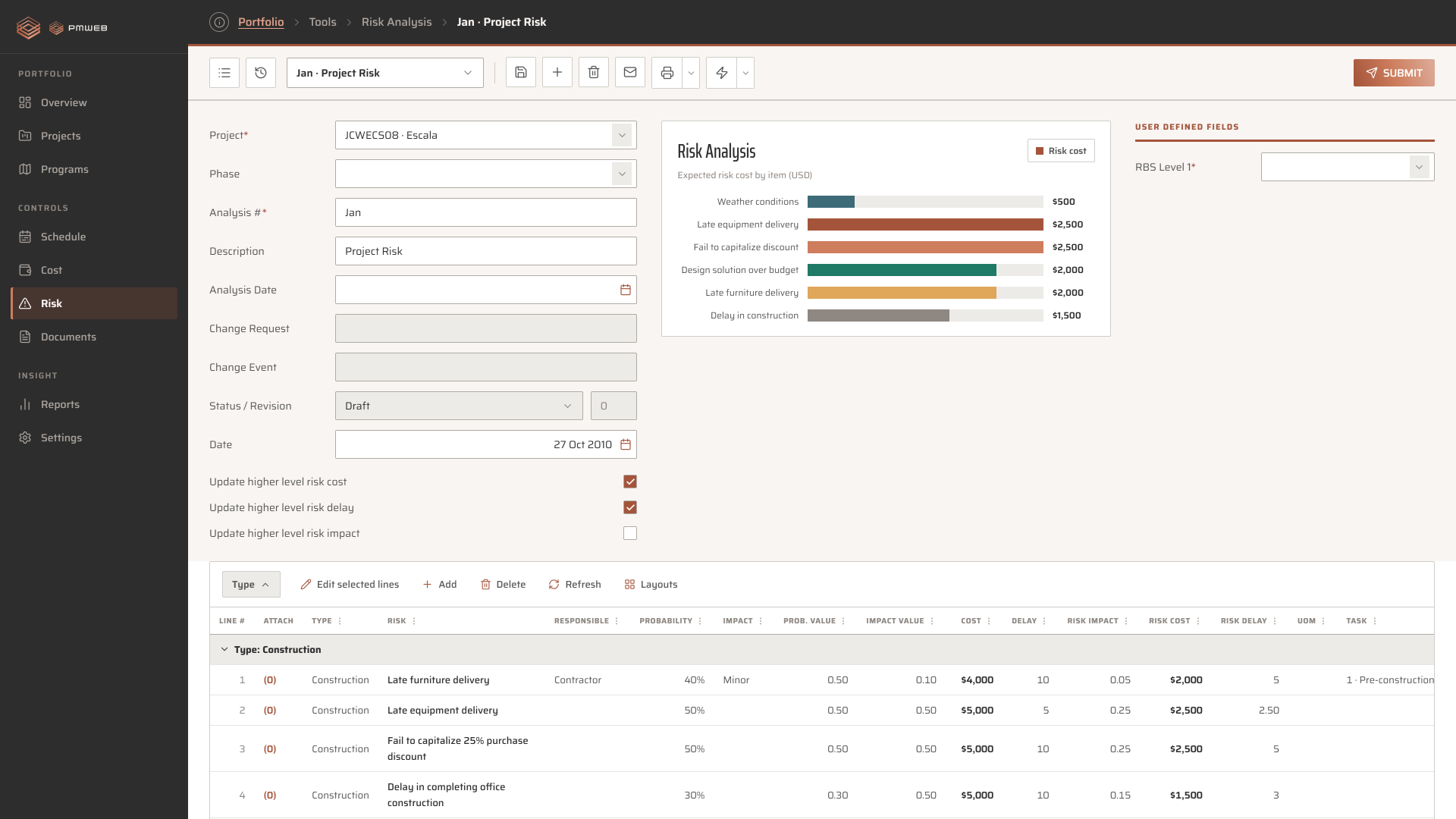

PMWEB risk analysis module showing a project risk register with pre- and post-mitigation impact and probability

Report the risk register and expected risk value

The data captured in the risk analysis feeds the risk register report, which can be shared across stakeholders. The report shows pre-mitigation and post-mitigation likelihood, impact, and exposure for each risk, and can group risks by project stage, risk category, and the response strategy used to treat them. The layout and format are fully configurable.

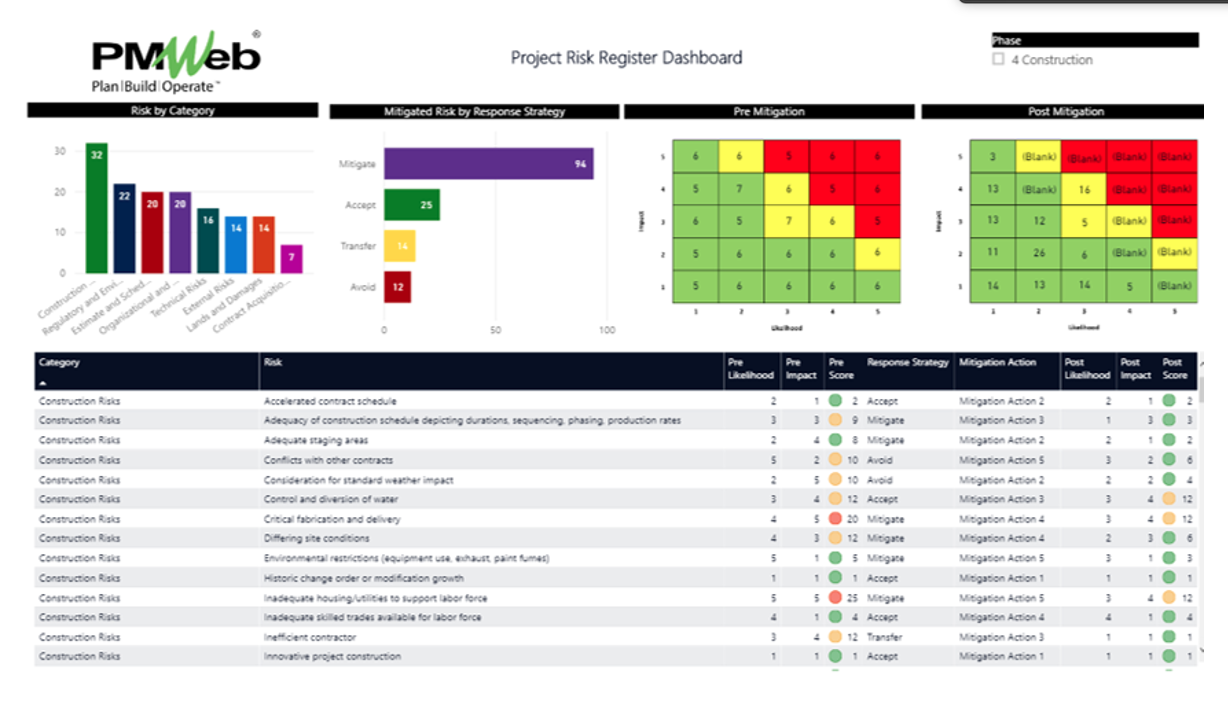

PMWEB project risk register report grouping risks by stage, category, and response strategy

The calculated expected exposure of each residual risk is reported as well. This estimated exposure becomes the basis for setting the contingency reserve in the project budget. The report can include visuals that summarize the expected contingency reserve by risk category, project phase, and selected response strategy. The risk register table displays each risk's pre-mitigation and post-mitigation likelihood, impact, and score, along with the residual risk cost and expected risk value.

Set contingency reserves from risk exposure

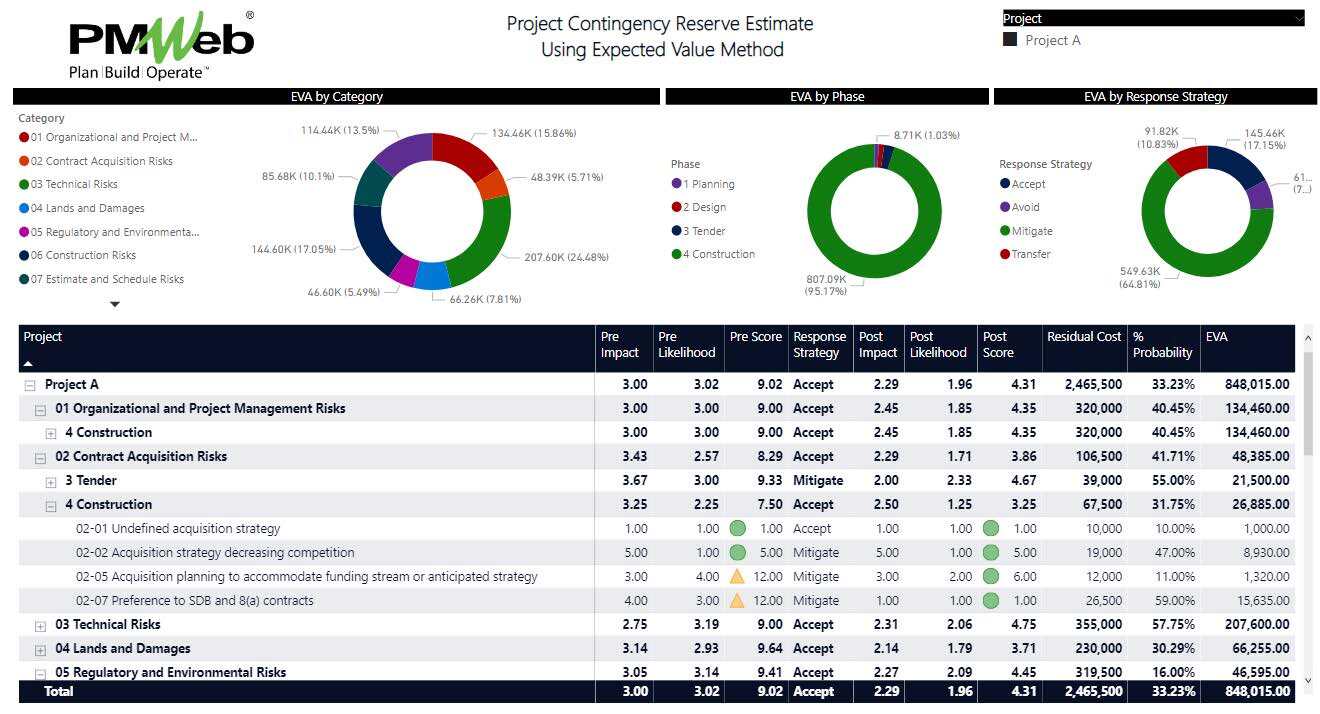

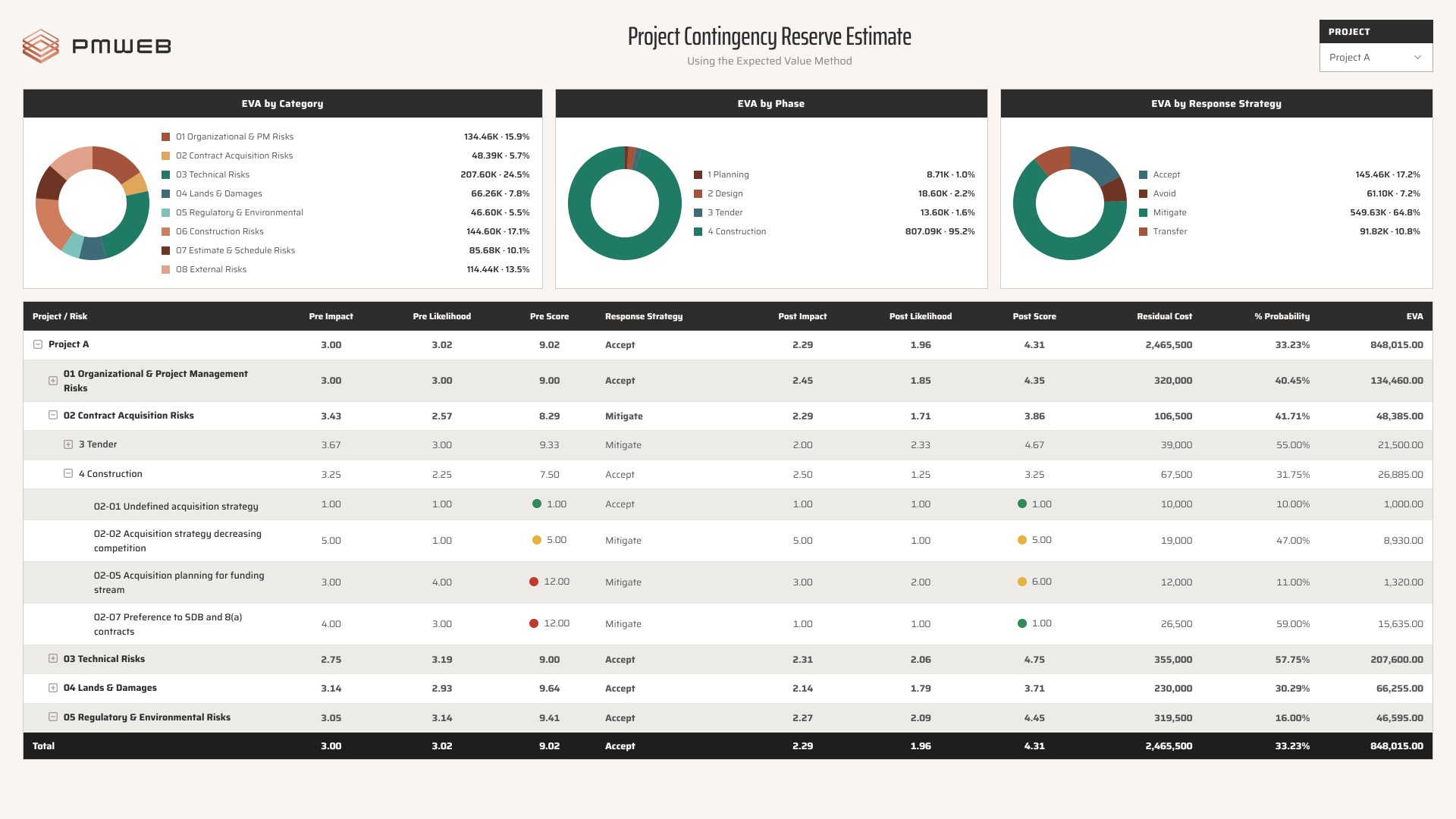

PMWEB contingency reserve estimate using the expected value method by risk category and project phase

Run quantitative risk analysis with Monte Carlo

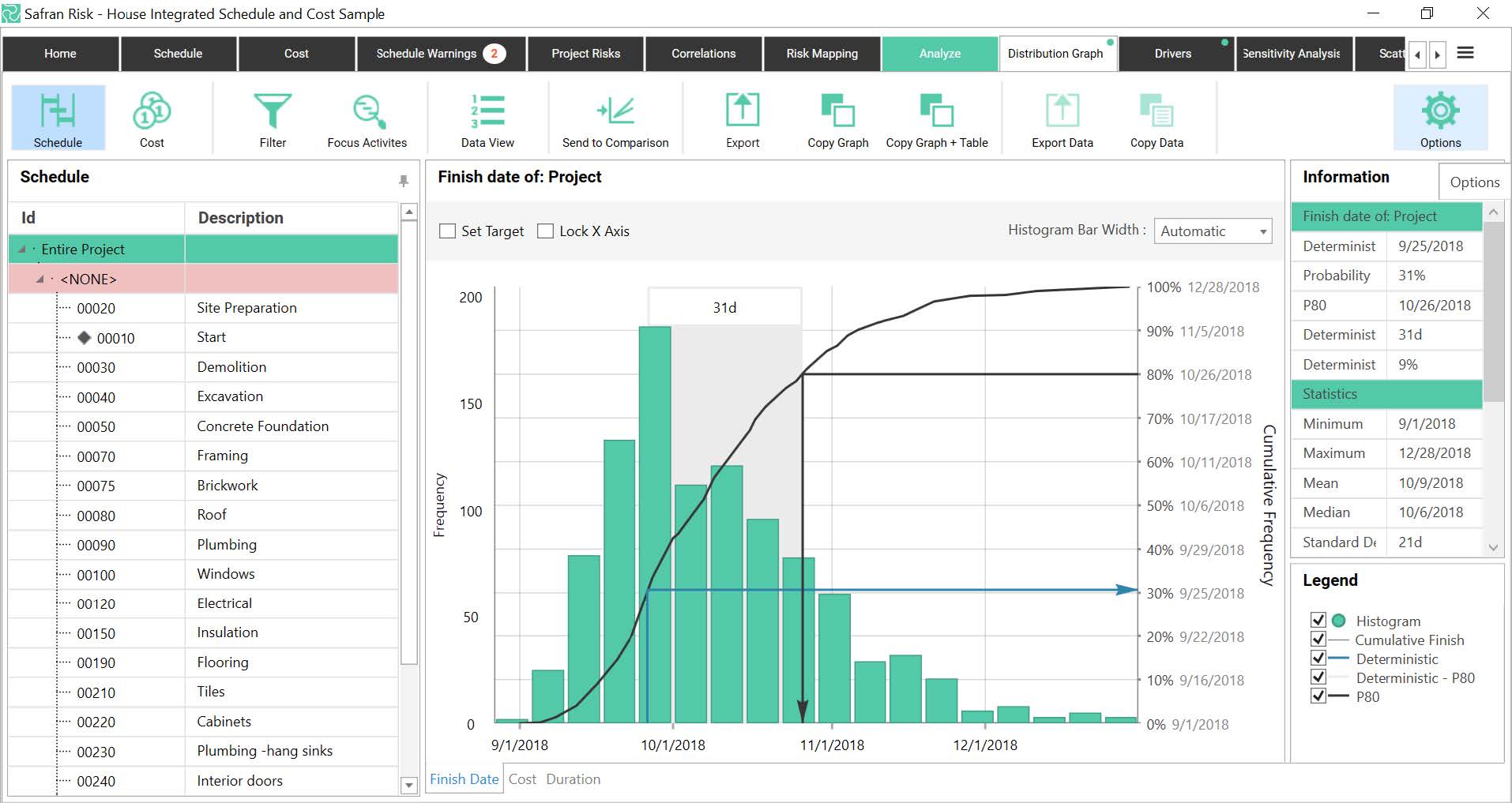

The consolidated risk register report, which includes likelihood and impact detail for each identified risk along with the associated schedule activity, can be imported into a Monte Carlo risk simulation application such as Safran to satisfy quantitative risk analysis requirements. The Monte Carlo simulation lets the risk team determine the probability of achieving the project's milestone dates and approved budget. It also identifies the 10 or 20 risks with the highest impact on the project, presented in a Tornado report.

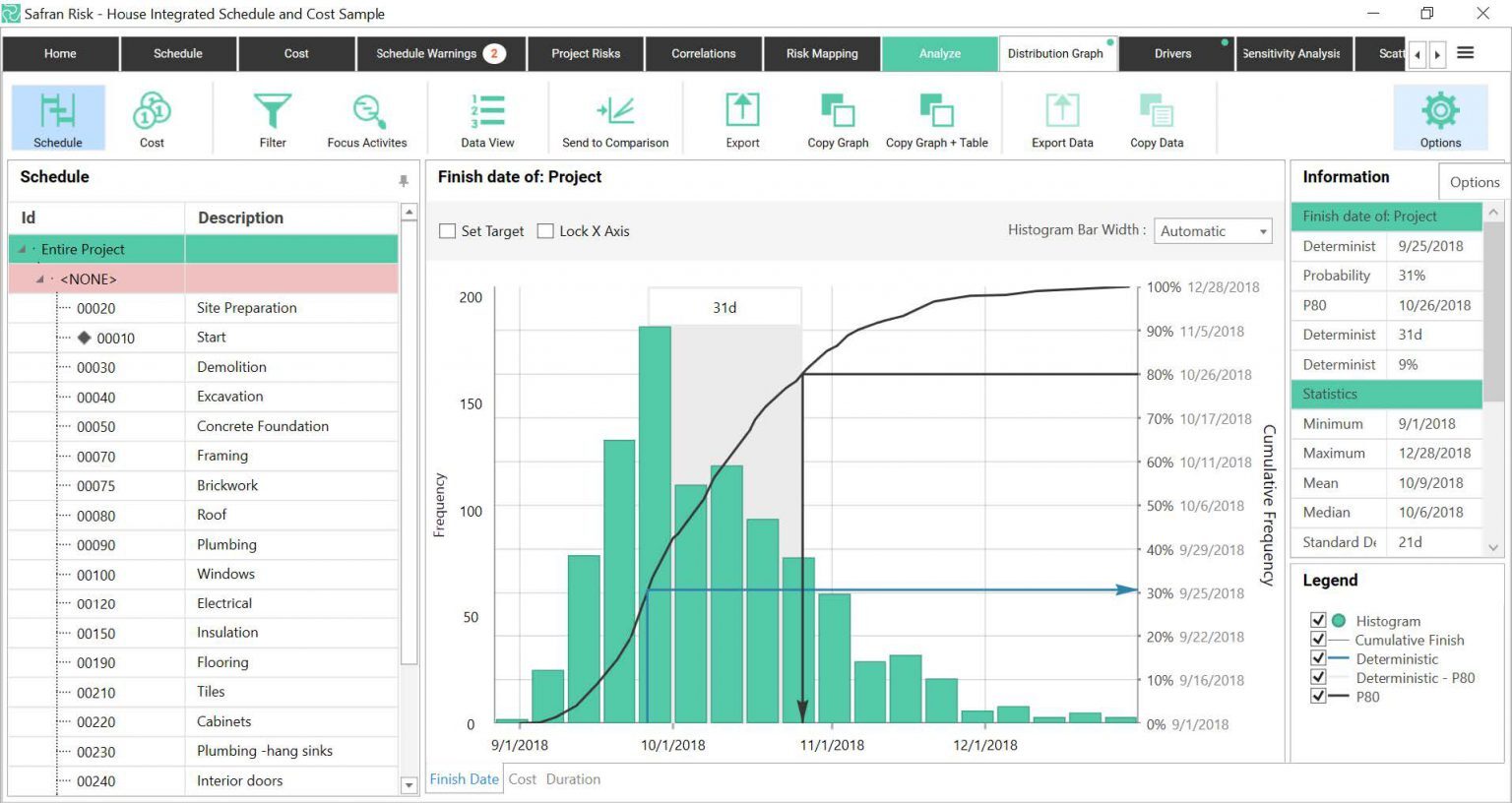

PMWEB risk register data imported into Safran for Monte Carlo quantitative risk simulation

Enforce governance with stage gates

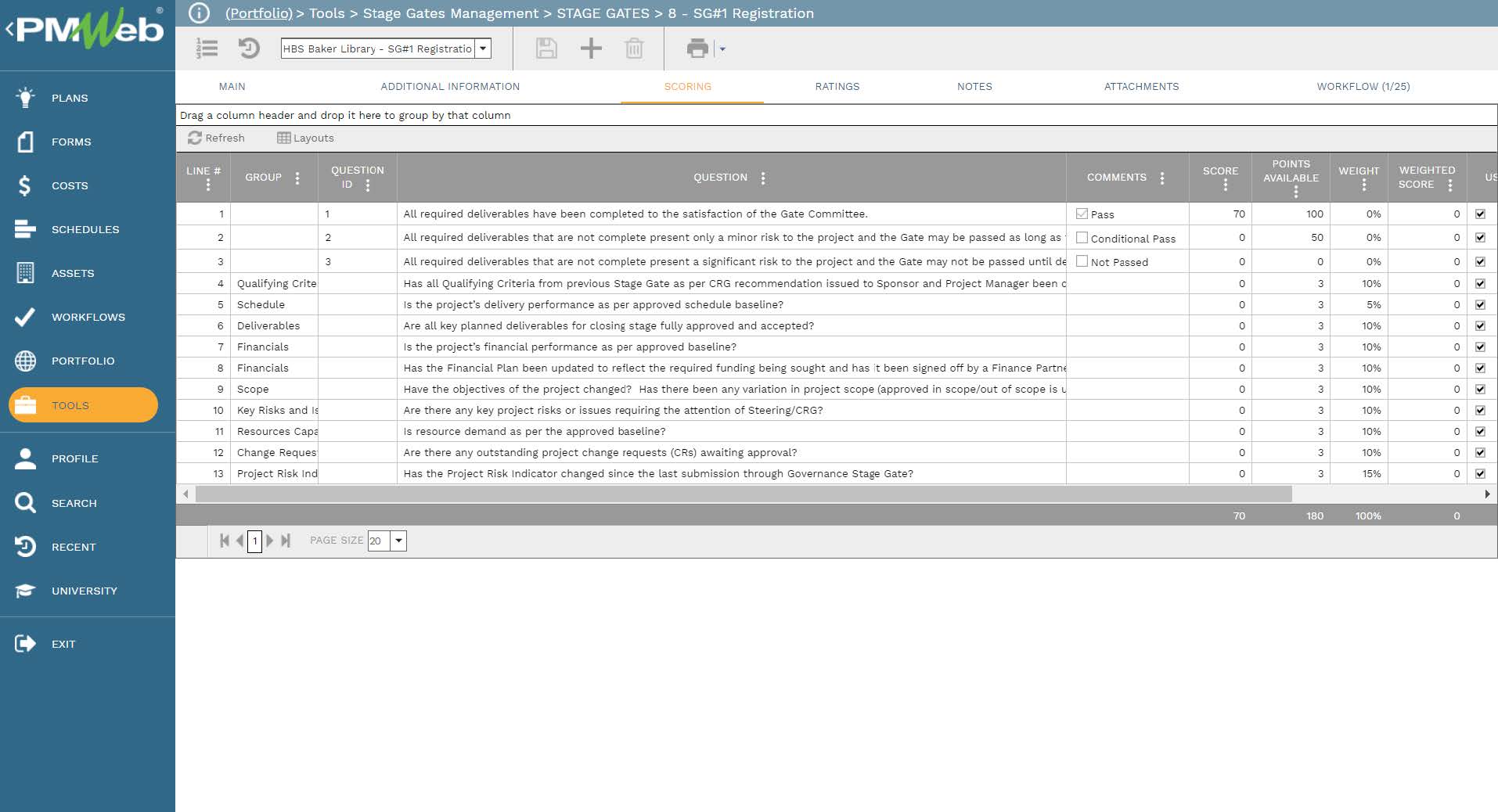

To enforce governance over project risk, the PMWEB stage gate module links each risk register to its relevant project life cycle stage. This makes the risk registers and other stage deliverables accessible in context. The scoring criteria for each stage include every item that must be assessed, including risk items, so the team can decide whether to continue as planned, make changes and then proceed, or terminate the project. Each score item carries its own weighted value to reflect its importance to the "Go / No-Go" decision.

Monitor and control risks during execution

As the project moves into execution, risks must be monitored and controlled. This means appending the risk registers with newly identified and emerging risks and updating the assessment of existing ones. You can add measures to report on the performance of the risk management process, and generate reports that filter and select the risks that need to be watched, monitored, and controlled.

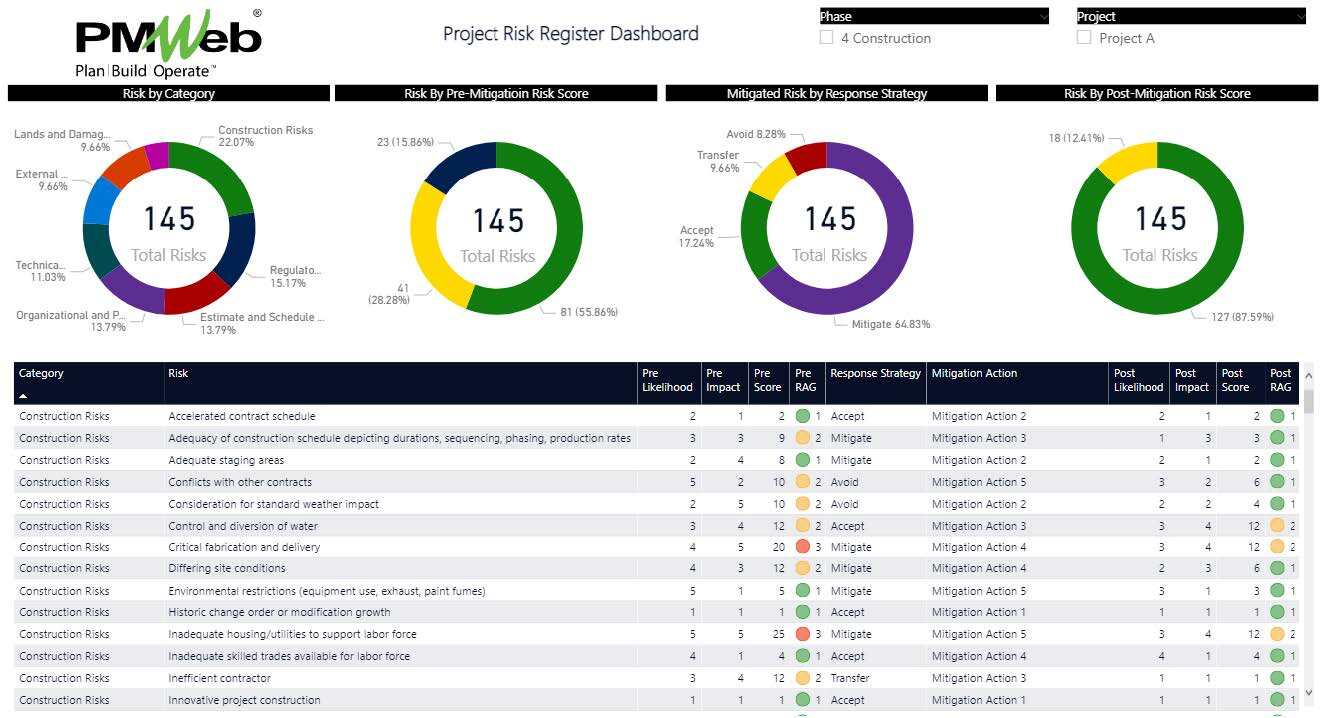

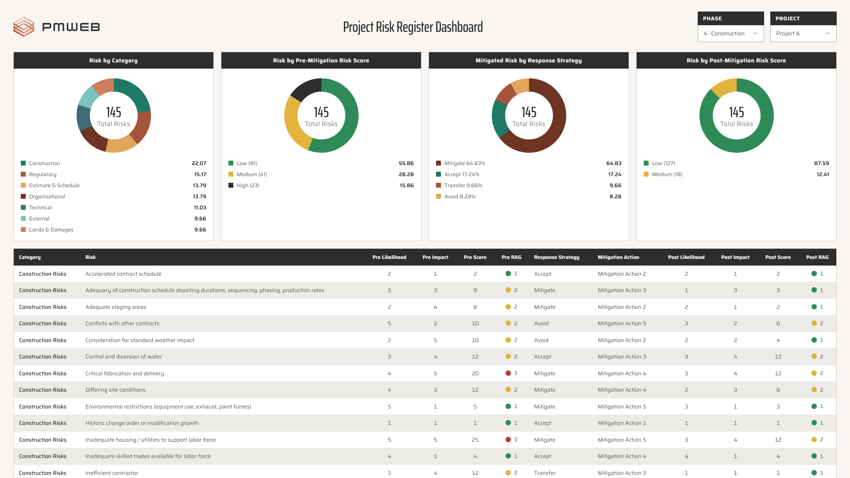

PMWEB risk register dashboard for monitoring and controlling risks during execution

Link occurred risks to changes and contingency drawdown

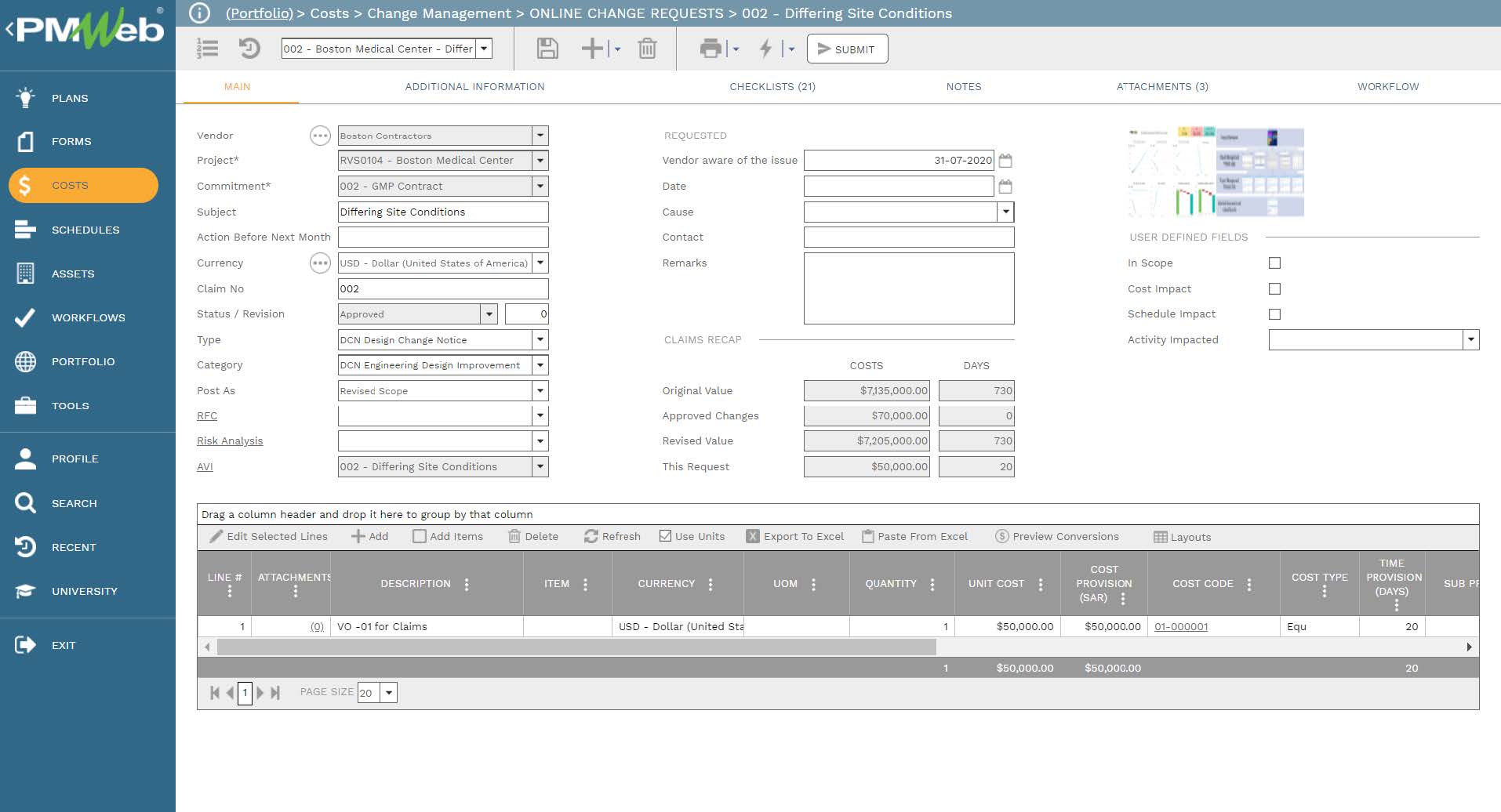

Monitoring and controlling risk also means capturing the issues that stem from risks that have actually occurred. For those risks, the PMWEB potential change order module captures the issue details and links them back to the risk register where the risk was originally identified, assessed, evaluated, and responded to. When resolving an issue requires a change, PMWEB can generate a change order from approved potential change orders to modify the commitment contract tied to the occurred risk.

The PMWEB change event module can also link every issued change order. This documents the response to the impact of occurred risks and the budget adjustments made, whether transferring funds from reserve cost accounts to other scope-of-work cost accounts or increasing the project baseline budget. The change event can also link back to the risk register where the risk was first identified, tracing the reasons behind each change.

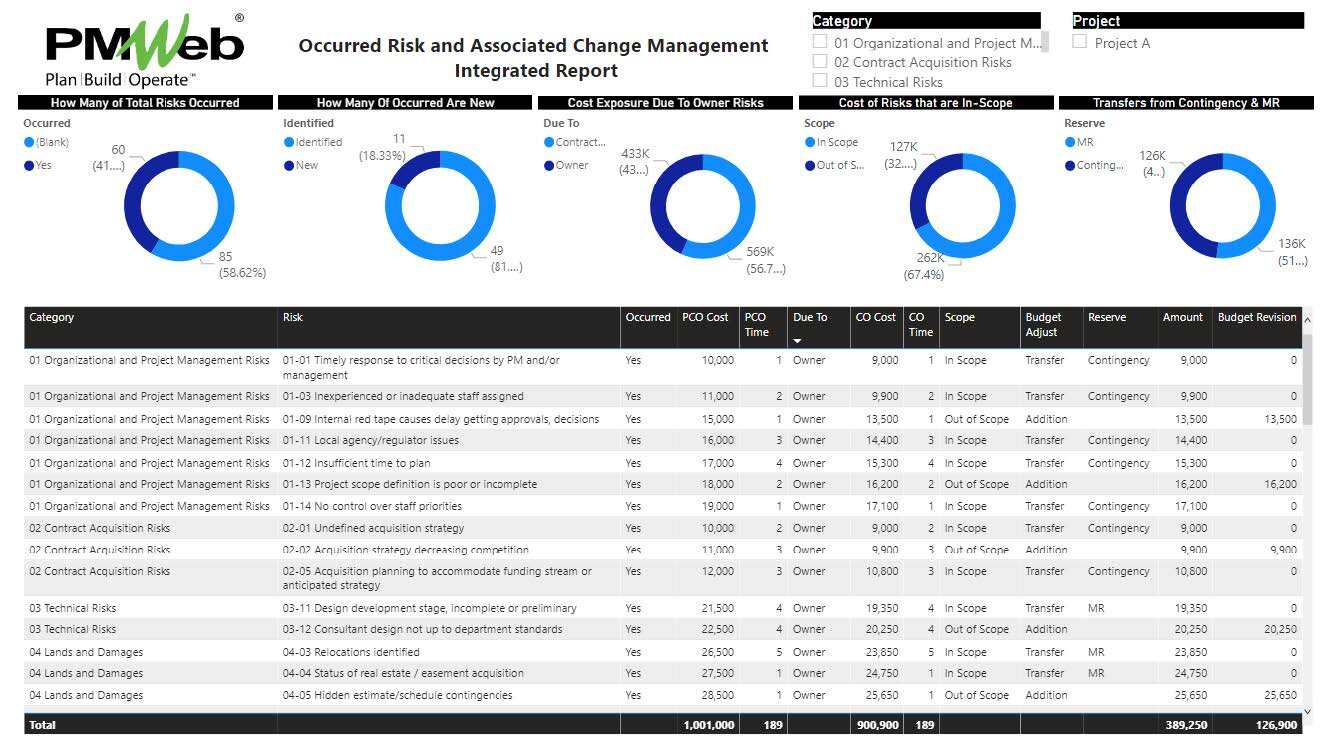

Because PMWEB integrates risk analysis, issues or potential change orders, and change orders, you can generate a single report detailing all potential changes and changes the project was subject to because of risks that actually occurred. This integrated risk-change report gives stakeholders insight into how risk has affected what was originally planned.

PMWEB potential change order capturing an issue from an occurred risk and linking it to the risk register

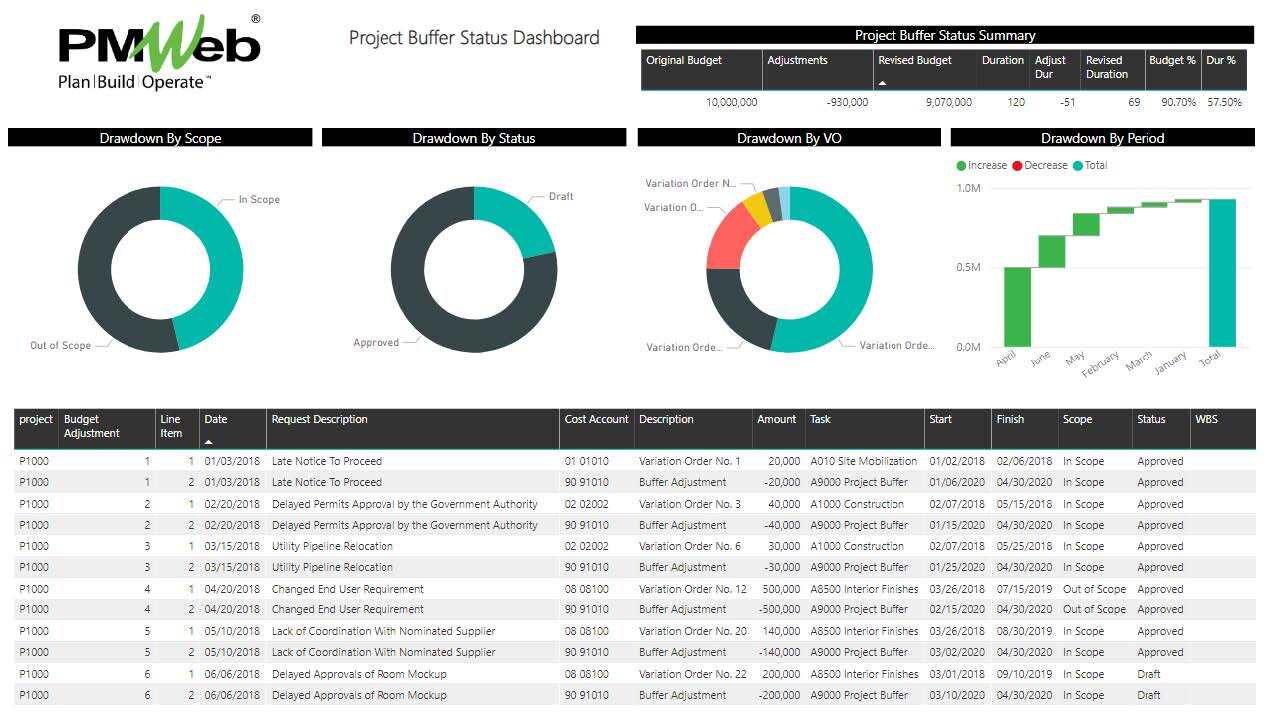

PMWEB can also report on contingency reserve drawdown as risks occur and force changes to the original plan. The report draws these details from the PMWEB budget and budget request module, which transfers funds from the contingency reserve cost center to the affected scope-of-work cost centers. It can also report on the time buffer activity associated with the contingency reserve cost center.

Capture lessons learned for continuous improvement

To build a culture of continuous improvement, the risk team should turn the knowledge and lessons gained into risk registers pre-populated with the known risks for each category. Reusing these templates on future projects speeds up risk identification and helps ensure the risk list is comprehensive. The lessons learned register report should be one of the deliverables from every post-project review workshop.

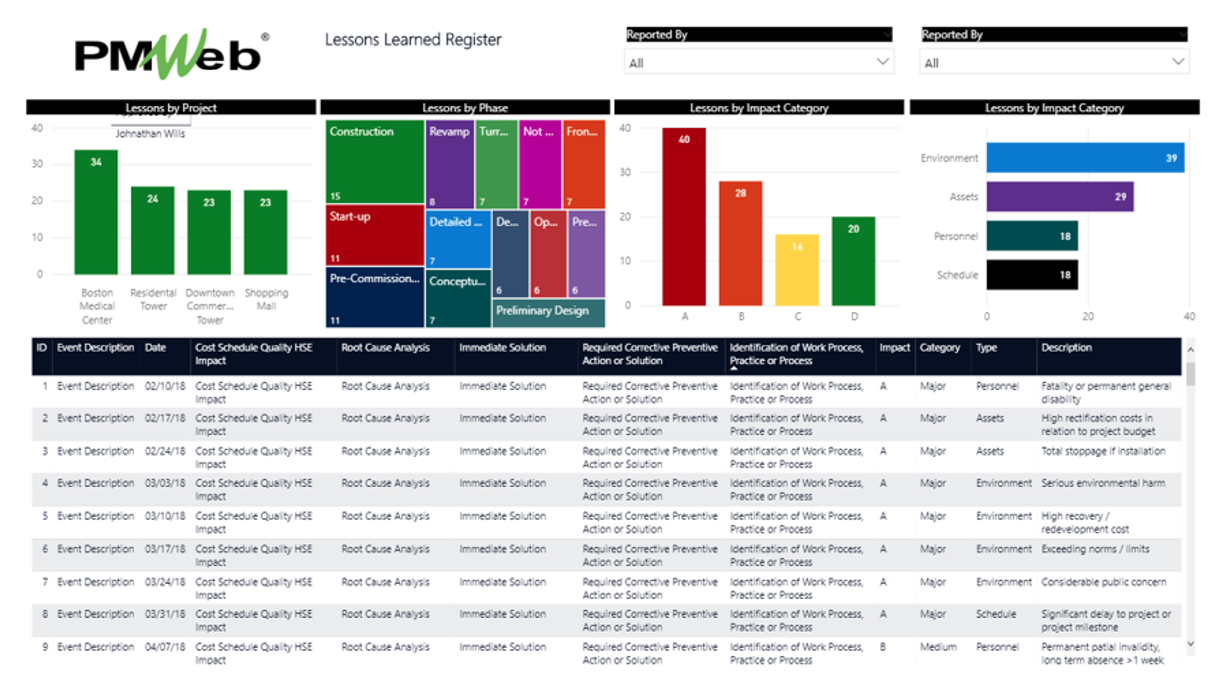

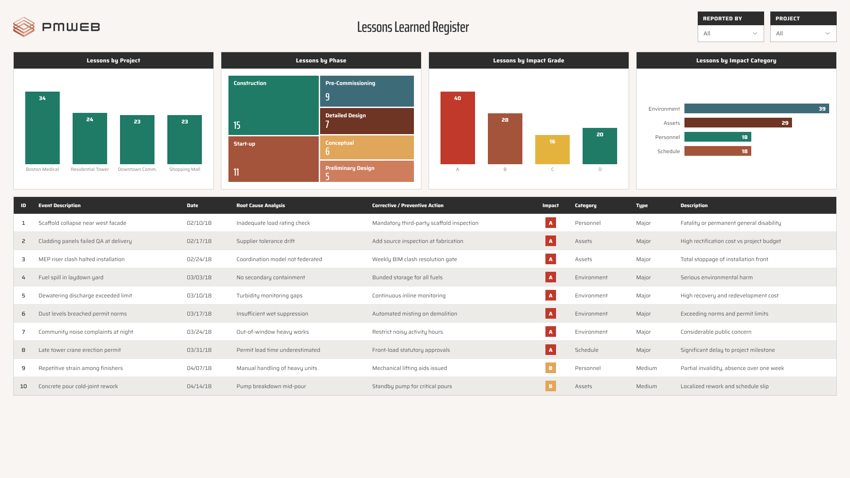

PMWEB lessons learned register with predefined risks for reuse on future projects

Keep risk documentation, workflow, and accountability in one system

As with every other business process in PMWEB, the team can attach supporting documents to each risk template above. It helps to add a description to each attachment so readers understand what they are viewing, and to link related transactions or records from other PMWEB business processes.

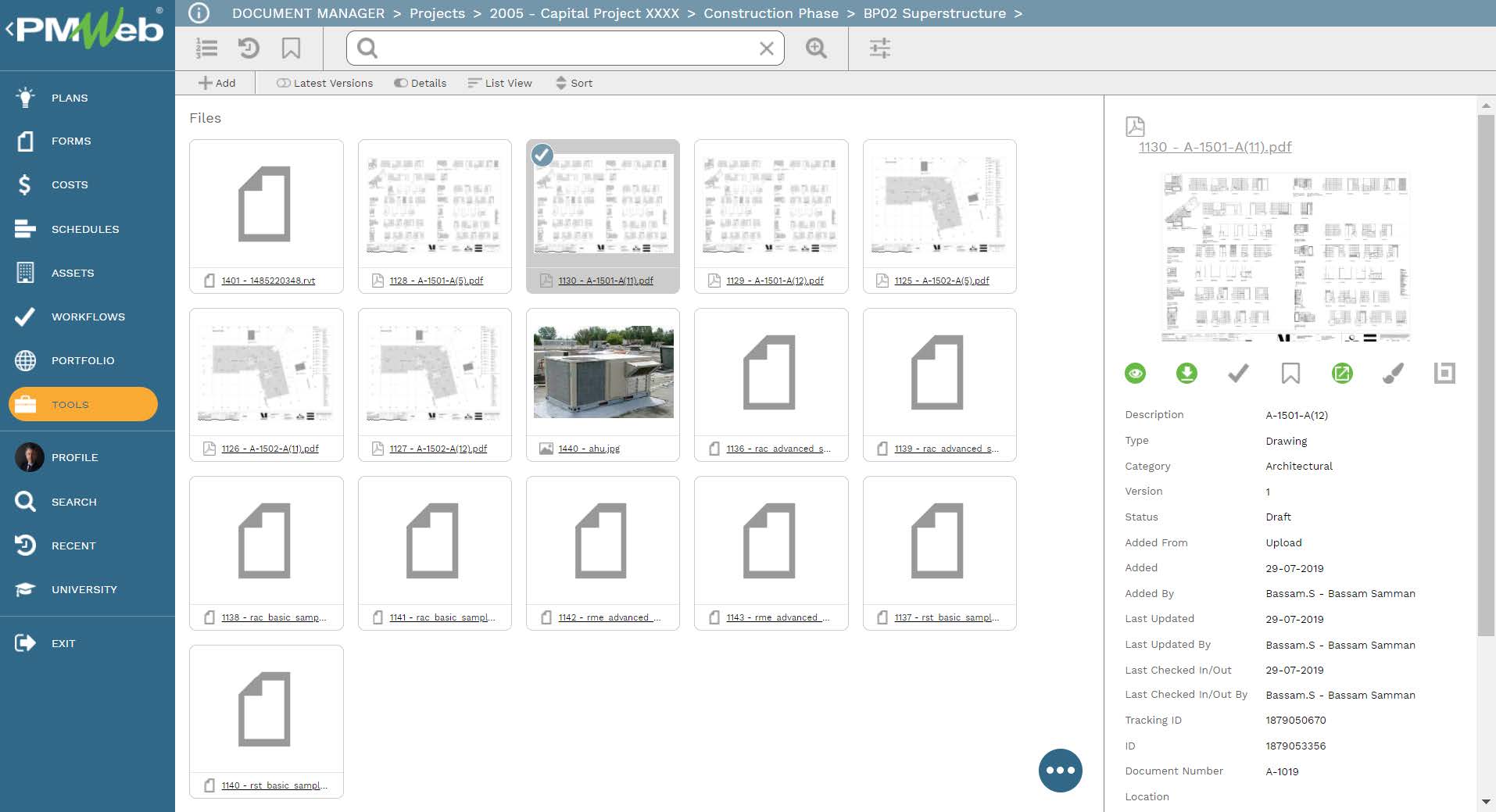

Those supporting documents, whatever their type or source, should be uploaded and stored in the PMWEB document management repository. PMWEB lets you create folders and subfolders that mirror the physical filing structure used for hardcopies, and set permissions so only authorized users have access. Users can also subscribe to a folder to be notified when documents are uploaded or downloaded.

Pmweb-print

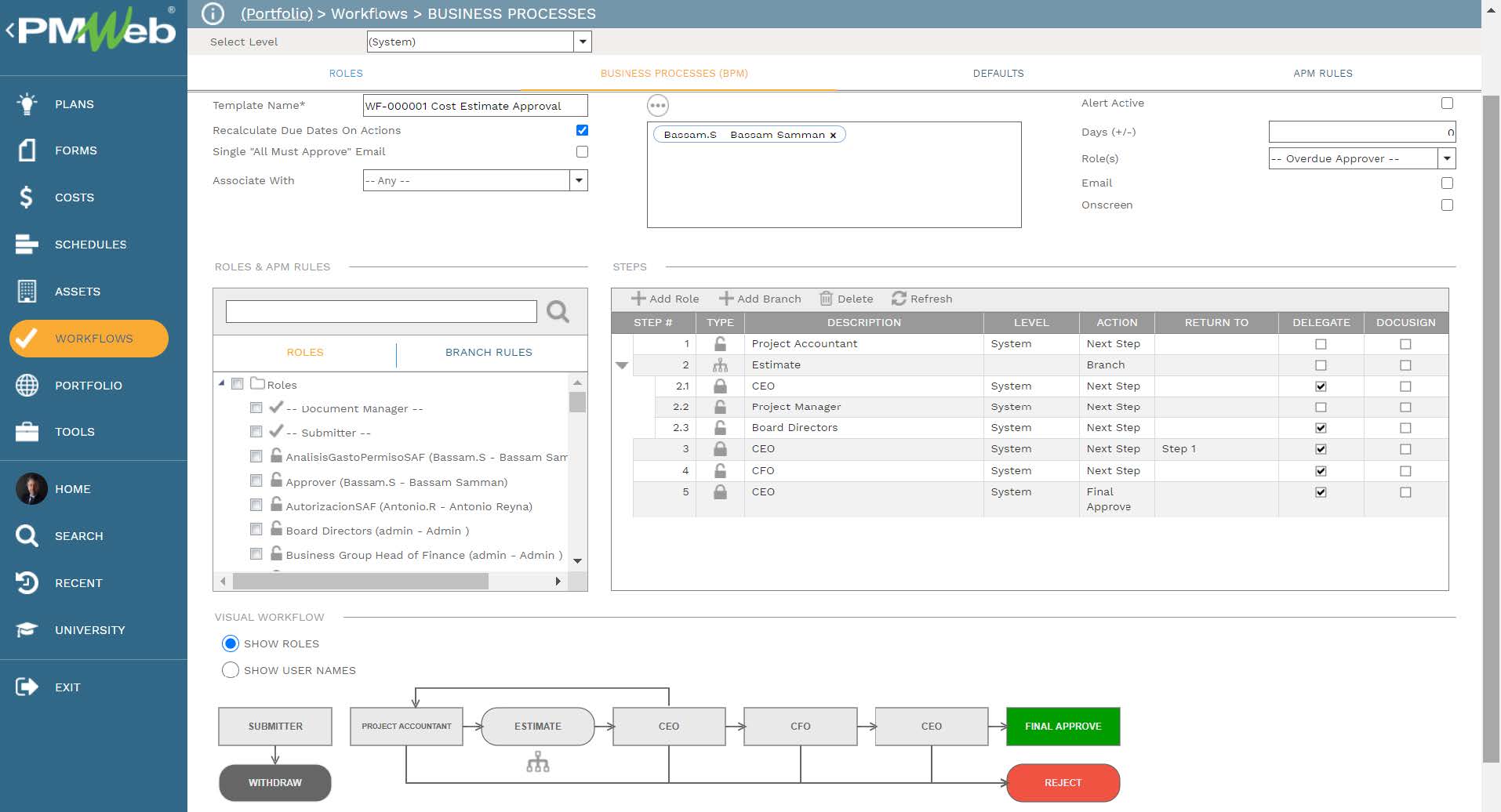

To enforce transparency and accountability across these processes, add a workflow to each template that maps the submit, review, and approve tasks; the roles assigned to each task; task duration and type; and the actions available. The workflow can reflect the approval authority levels set in the Delegation of Authority (DoA) document.

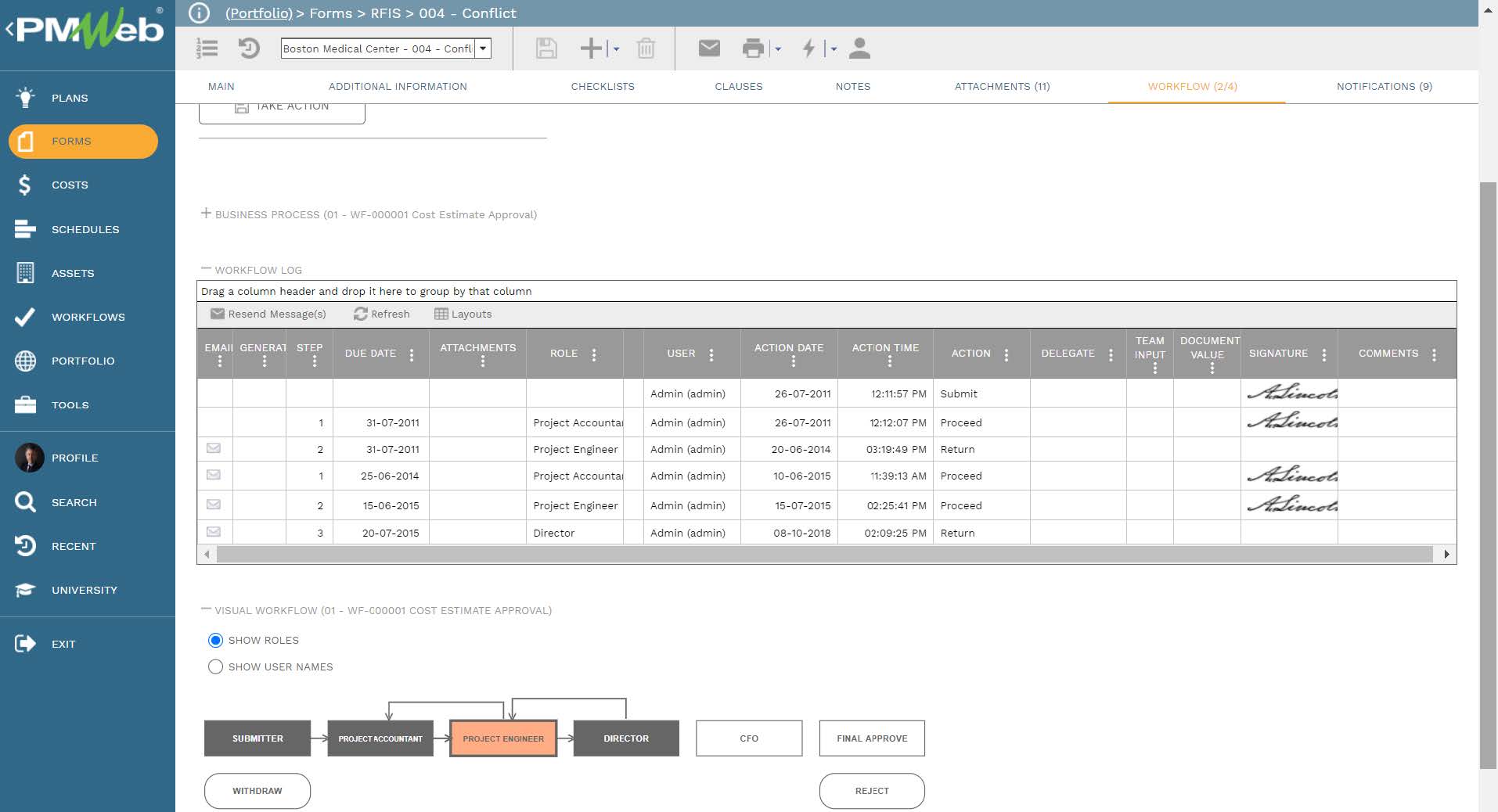

When a transaction is submitted for review and approval, the workflow tab on the template captures both the planned tasks and the actual history: the action date and time, who acted, the action taken, comments made, and whether team input was requested.

Bringing proactive risk management together on one PMIS

Managed on a single PMIS, proactive risk management stops being a spreadsheet exercise and becomes part of how capital projects are governed. Risk registers feed contingency reserves, stage gates enforce Go / No-Go discipline, occurred risks trace directly to change orders and budget drawdown, and lessons learned carry forward to the next project. That end-to-end traceability is what lets owner-operators accept more risk with confidence and protect cost and schedule across the portfolio.

See how PMWEB brings risk registers, contingency planning, stage gates, and integrated reporting into one platform: request a PMWEB demo, or explore the Control & Execution solutions and Visibility & Analysis capabilities that power it.

Frequently asked questions about project risk management software

What is proactive project risk management?

Proactive project risk management is the practice of identifying, assessing, quantifying, and responding to risks before they affect a project's cost, schedule, or scope. Its goal is not to eliminate risk but to increase an organization's ability to take on risk while controlling the downside, which improves the return on investment of its projects.

How does a PMIS support project risk management?

A Project Management Information System (PMIS) supports risk management by hosting risk registers, contingency reserve calculations, stage gate scoring, and change management in one integrated platform. Because the modules share data, every risk can be traced from identification through its cost exposure, response, and any resulting change order, giving stakeholders a single source of truth across the portfolio.

What is a project risk register?

A project risk register is a structured record of identified risks that captures each risk's category, likelihood, and impact both before and after mitigation, along with its expected cost exposure. In PMWEB, the register also calculates Risk Cost by multiplying a risk's residual cost impact by its probability of occurrence.

How are contingency reserves calculated from risk?

Contingency reserves are set from the expected exposure of residual risks. Each risk's expected value equals its residual cost impact multiplied by its probability of occurrence, and the sum of those expected values, often refined with Monte Carlo simulation, becomes the basis for the contingency reserve held in the project budget.

What is the role of stage gates in risk management?

Stage gates enforce governance by requiring a Go / No-Go decision at the end of each project life cycle stage. Risk assessment is one of the weighted criteria scored at each gate, so the team can decide to continue as planned, make changes and proceed, or terminate the project before committing further budget.
