Cost overruns, missed forecasts, and limited visibility—these are common challenges faced by owner-operators managing capital construction projects. The reason? Project data is often scattered across systems, manually maintained, or inconsistently coded.
As budgets grow and portfolios expand, accurate expense tracking becomes imperative. The solution? A unified Cost Breakdown Structure (CBS) and Work Breakdown Structure (WBS) that connects the field to finance, the estimate to actuals, and individual projects to the broader capital strategy.
In this blog, we’ll walk through the practical steps to create and implement WBS and CBS and show how Project Management Information System (PMIS) tools like PMWeb bring this process to life.
The WBS: Organizing scope into manageable components
The Project Management Body of Knowledge (PMBOK®) defines the WBS as a “deliverable-oriented hierarchical decomposition of the work to be executed by the project team.”
Simply put, it provides a logical framework to break down a project’s scope into smaller, manageable work packages. These packages align with how the project will be scheduled, executed, and measured.
A typical WBS might include:
- Phase (e.g., design, construction, closeout)
- Location or zone
- System or discipline
- Contracted package or subcontractor
By structuring the WBS with foresight, project managers can more effectively track progress, assign responsibilities, and align scheduling and cost reporting with actual work on the ground.
The CBS: Structuring cost data for transparency and forecasting
Where the WBS defines what is being done, the Cost Breakdown Structure (CBS) defines how much it costs.
The CBS provides a hierarchical breakdown of direct and indirect project costs, including labor, materials, equipment, subcontractors, and overhead, as well as contingency and management reserves.
While the project management team typically creates the WBS to define scope, responsibilities, and schedule, the finance or commercial departments develop the CBS.
Additionally, a Work Breakdown Structure in construction may be customized per project, whereas a Cost Breakdown Structure should remain standardized across projects to ensure consistency in cost management and reporting.
Real-world example: Tracking HVAC costs with WBS and CBS
Consider a public library construction project.
In the WBS, a deliverable like “Install HVAC system” falls under the Construction phase. In the CBS, cost categories include labor, materials, and subcontractors.
To track this task accurately:
- The cost of HVAC ductwork materials gets tagged to the “Install HVAC system” deliverable (WBS) and the “Materials” category (CBS)
- Labor costs for installation are tagged to the same deliverable but under the “Labor” category in the CBS
This dual tagging provides complete visibility into:
- Total cost of the HVAC task
- Cost breakdown by labor vs. materials
- Budget performance relative to scope
In PMWeb, this relationship is built into the platform’s core.
From long-term CapEx planning to construction execution and asset management, it empowers owner-operators to gain portfolio-wide traceability.
Every cost record—a budget line, commitment, invoice, or timesheet—can be tracked to a specific deliverable (via WBS) and a cost category (via CBS).
Learn: Strategies for Overcoming PMIS Objections
Why WBS and CBS matter for cost management
The true value of Cost Breakdown Structure and Work Breakdown Structure in construction emerges when they’re applied consistently and used as the foundation for project-wide cost control. Here’s why they’re essential.
1. Consistency across the organization
Standardized WBS and CBS frameworks create a common language across projects, vendors, and business units. This eliminates silos and allows financial and operational data to be rolled up cleanly for portfolio-level planning, audits, and performance reviews.
2. Predictive control through integrated analysis
When scope, cost, and schedule are connected, project teams can move beyond reactive reporting. Integrated structures enable variance tracking, scenario modeling, and dynamic forecasting, shifting cost control from a backward-looking exercise to a forward-focused function.
3. Financial transparency at the work package level
By assigning every cost entry to a defined scope of work, teams can pinpoint exactly how budgets are being consumed. This transparency allows for early identification of anomalies, real-time monitoring of burn rates, and corrective action before small issues escalate.
4. Stronger alignment between finance and field teams
A clear structure fosters collaboration. Finance teams gain the context behind cost drivers, while project managers better understand the financial impact of technical progress. With shared data and terminology, decisions can be made faster, with fewer delays and less conflict.
Using WBS and CBS for cost tracking: A step-by-step guide with digital best practices
To turn structure into strategy, it’s vital to connect WBS and Cost Breakdown Structure in construction to the schedule, budget, and actual cost processes. Here are the steps to operationalize them.
1. Define a standard framework across the portfolio
Every effective cost management system begins with a shared understanding of project scope and spending. This requires alignment across stakeholders, such as project managers, finance teams, and contractors, on a common WBS and CBS structure.
For example: In your WBS, Levels 1–3 might consistently follow a format like: Stage > Facility > System (e.g., Construction > Hospital Tower B > HVAC System) Your CBS might reflect your financial coding hierarchy: Cost Group > Category > Type (e.g., Direct Costs > Subcontractor > Mechanical) |
This standardization is essential for organizations managing multiple capital projects. Without it, automation and portfolio-level analysis are nearly impossible.
In PMWeb, the Cost Account module forms the backbone of the CBS. It supports up to 16 hierarchical levels, each allowing codes up to 10 digits long.

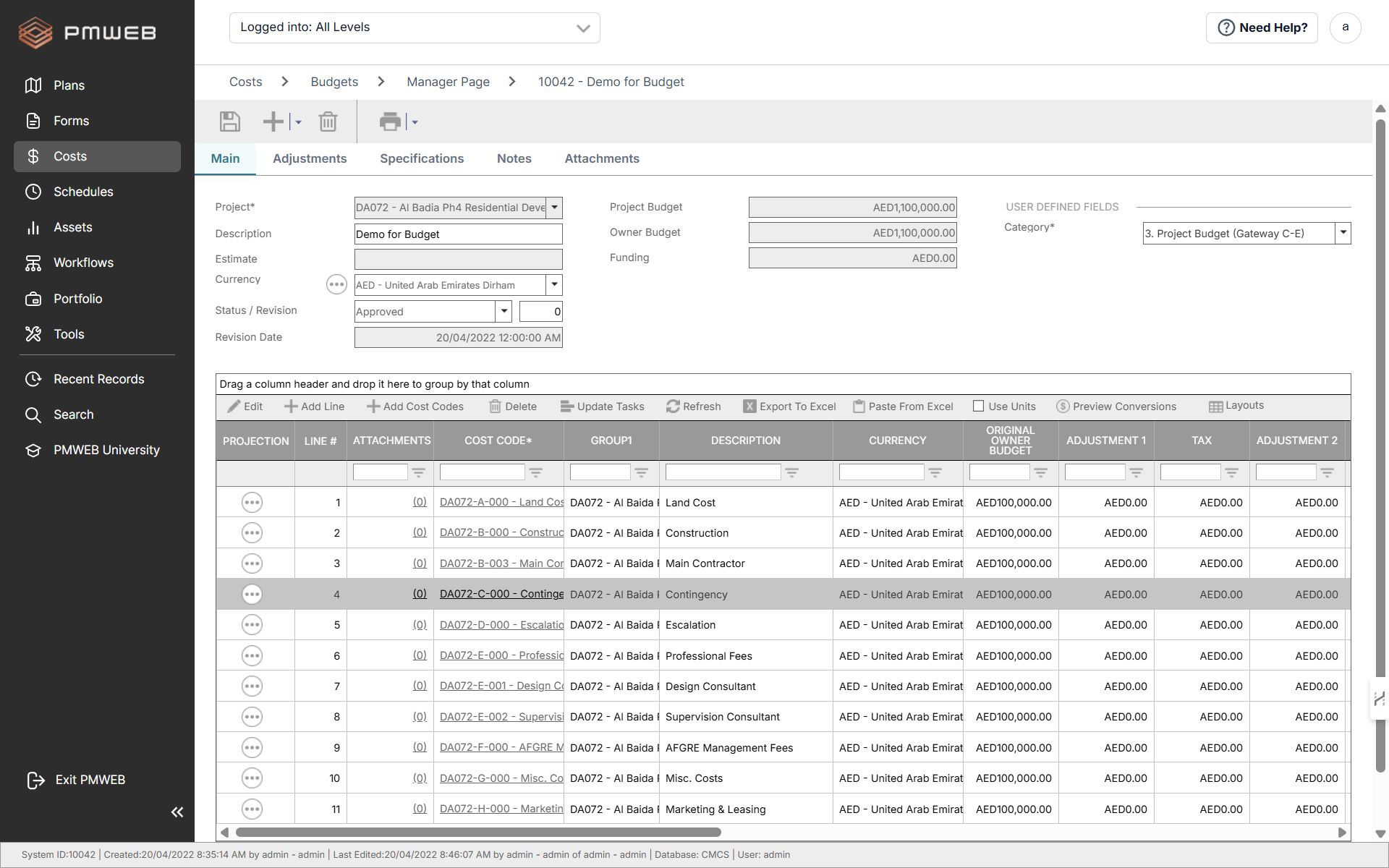

Caption: Construction budget view in PMWeb, detailing grouped line items by cost category
These levels can be mapped to existing financial account structures, helping bridge the gap between project controls and enterprise finance.
Owner-operators are strongly encouraged to set WBS standards for contractors when developing project schedules to enhance WBS-based cost performance reporting.
Caption: Imported Primavera P6 schedule linked to WBS elements in PMWeb
At a minimum, the first four WBS levels should be uniform across all capital projects. These typically cover:
- Project life cycle stages
- Bid packages
- Building systems
- Key system components
Caption: Primavera P6 schedule view showing activity costs and Gantt chart timeline
Once a schedule is imported into PMWeb, standardized and project-specific WBS levels become immediately available for cost planning and reporting.
Here’s how one practitioner described the power of a well-structured WBS:
Caption: Commentary on WBS ownership for improving accountability and filtering schedules
Best practice: Before rolling out a standardized WBS and CBS across all projects, test them on a representative pilot project. This makes broader implementation smoother and gives you a real-world case to demonstrate the benefits to stakeholders. |
2. Align cost structures with the project schedule
Whether managing a hospital, university, or infrastructure program, every owner-operator needs a cost breakdown structure and construction strategy that supports data-driven oversight.
In most capital projects, schedules are developed with tools like Primavera P6. Contractors typically submit activity-loaded schedules, which define when work is expected to happen.
To ensure this schedule can be used for financial control, each activity must be tied to a WBS element and cost category. This allows owner-operators to trace every dollar, who it’s being paid to, when it’s being spent, and what scope it’s delivering.
To bring this data into PMWeb:
- Export the cost-loaded schedule from Primavera P6 to Excel
- Import it into PMWeb’s Cost Estimate module using the Detailed Import function
Caption: PMWeb estimate module showing itemized cost breakdown in a capital project
This import maps key data fields such as:
- Schedule activity ID and description
- WBS level
- Estimated cost per activity
- Expense category (typically “Contract”)
- Vendor or contractor name
Once imported, owner-operators can assign CBS levels to each activity or estimate line items, break down complex items into more granular cost lines, and add elements like owner-supplied equipment, third-party testing, installation by others, or indirect costs.
Contingency and management reserves can also be included. The result is a comprehensive, structured cost estimate aligned with the total planned capital investment and sets the stage for accurate budgeting and performance management.
Best practice: Use a consistent alphanumeric coding system that embeds both WBS and CBS references in schedule activity IDs and cost account codes. This ensures updates to one structure cascade appropriately across the project plan and financials. |
3. Generate budgets and commitments
With a structured estimate in place, the next step is to formalize:
- Budgets: Roll up the estimate data by CBS level
- Commitments: Track contractual agreements with vendors and contractors
Caption: Detailed construction budget breakdown in PMWeb, grouped by cost categories
The strength of this step lies in the ability to roll up or drill down as needed. In PMWeb:
- The Budget module aggregates data by CBS levels and allows you to assign scheduled activities to each line item.
- To align cost and time, it's recommended (but not mandatory) that the schedule include summary-level activities that mirror the CBS structure.
Commitments, on the other hand, are more detailed:
- Each line item in a PMWeb Commitment is tagged with a schedule activity, WBS and CBS codes, vendor, and expense category.
- This ties contractual obligations to specific scope, timeline, and budget codes, providing traceability across the lifecycle.
PMWeb also supports integrated change management via:
- Budget Requests for internal changes
- Potential and formal Change Orders with full lifecycle tracking
- Change Events that connect budget and commitment changes in one view
Caption: PMWeb Change Management screen for office modifications
Best practice: To enforce financial discipline, ensure that the team creating the budget is distinct from those issuing commitments. Budgets should define the spending plan, while commitments formalize approved work. |
“We put the product through its paces… It has been invaluable having all of our documents, figures, and reporting located in one proficient program.” — Heather Michaelson, Administrator, Johns Hopkins University |
4. Track earned value and actual costs
With structures and documents in place, PMWeb enables real-time tracking of cost performance.
- Earned Value is calculated through interim progress invoices. PMWeb imports percent-complete data from the updated schedule to compute earned vs. planned costs.
- Actual payments are logged manually or imported from ERP and finance systems, and every transaction is tagged with WBS and CBS codes to ensure data integrity.
PMWeb supports this via:
- Interim progress invoices that tie payment to the percent complete
- Payment tabs within invoices that log disbursements from finance
- Miscellaneous invoices and journal entries, all coded by WBS/CBS, ensuring consistency across all financial records
Caption: PMWeb Progress Invoice module showing financial breakdown
PMWeb also includes tools for estimating and tracking team hours, allowing owner-operators to also account for their internal resource costs.
- The Resource Requirements module defines planned labor by project phase or deliverable
- The Timesheet module captures actual hours worked, with each hour categorized by rate type (regular, overtime, weekend) and tagged to the appropriate CBS and WBS codes
Caption: PMWeb labor resource planning screen for the construction phase
External consultants and vendors remain part of commitment costs, not internal labor tracking.
Best practice: To prevent subjective or inconsistent progress reporting, establish predefined “rules of credit” for each major work package. These should quantify how and when value is earned—for example, “50% credit upon equipment delivery, 50% upon installation.” |
Case Study: All Aboard FloridaManaging a $2.5B privately funded rail program required full visibility into budgets, real-time tracking of commitments, and streamlined approvals across multiple phases and teams. Using PMWeb, the project team deployed integrated cost tracking, forecasting, and document control—all built on Work Breakdown and Cost Breakdown Structures. This enabled granular oversight and ensured that all financial data remained connected throughout the project lifecycle. Results:
“PMWeb’s visual workflow and dashboard reporting allow for effective and timely decision-making.” — Alex Velazquez, Vice President, Controller |
Also Read: Real-Time Earned Value Reporting with Cost-Loaded Schedules and PMIS
Achieve capital clarity with PMWeb
Cost overruns. Delayed approvals. Incomplete forecasts.
The consequences of poor visibility aren’t always immediate, but they are inevitable. Without a unified view of scope, schedule, and cost, even the most well-funded capital programs are vulnerable to inefficiency, dispute, and loss.
That’s why leading owner-operators choose PMWeb as their strategic control center.
Unlike generic PMIS tools, PMWeb is purpose-built to enforce control at every level—from structuring the Work Breakdown Structure (WBS) and Cost Breakdown Structure (CBS) to automating approvals, validating forecasts, and maintaining complete audit trails.
With PMWeb, every dollar is traceable. Every activity is accountable. Every decision is data-driven.
Gain the control to lead with confidence—schedule a PMWeb demo today.
